Digging Deep into Underground Electricity Supply Pits

What Is Underground Power Pit Installation (And Why It Matters for Your Project)

Underground power pit installation is the process of placing a reinforced enclosure — typically concrete or fiberglass — at a property boundary to house electrical cables and equipment that deliver power via an underground service.

Here's a quick overview of how it works:

  1. Apply to your local utility provider with a site plan, load calculations, and proposed pit location
  2. Receive a design and offer from the utility, typically within 10-20 business days
  3. Accept the offer and make payment (usually within 30-45 business days of receiving it)
  4. Pit is installed by the utility at or near the property boundary, generally within 30 business days of design completion
  5. Hire a Registered Electrical Contractor (REC) to run mains from the pit to the building's main switchboard
  6. Permanent surface repairs (topsoil, pavement) are completed by field crews, typically within 6-8 weeks after installation

Costs generally range from $5,000 to $8,500, depending on complexity, equipment type, and local utility charges.

Underground pits serve as the critical handoff point between the utility's distribution network and your building's electrical system. They're standard practice for residential subdivisions, commercial developments, and any project where overhead lines aren't an option or aren't preferred.

I'm Don Larsen of RBC Utilities Inc., and since 2008 our team has delivered conduit systems and underground utility construction across the Carolinas — including the site coordination, trenching, and compliance work that makes underground power pit installation go smoothly for developers and general contractors. In this guide, I'll walk you through everything you need to know, from technical specs to the application process and beyond.

Components of an underground power pit network infographic - underground power pit installation infographic

Understanding Underground Power Pit Installation and Its Purpose

When we talk about an underground power pit, we are referring to a heavy-duty, reinforced structure designed to live just below the surface. Its primary job is to act as a distribution hub. Think of it as the "mailbox" for your electricity; the utility company delivers the power to this point, and from there, it’s routed into your specific building or home.

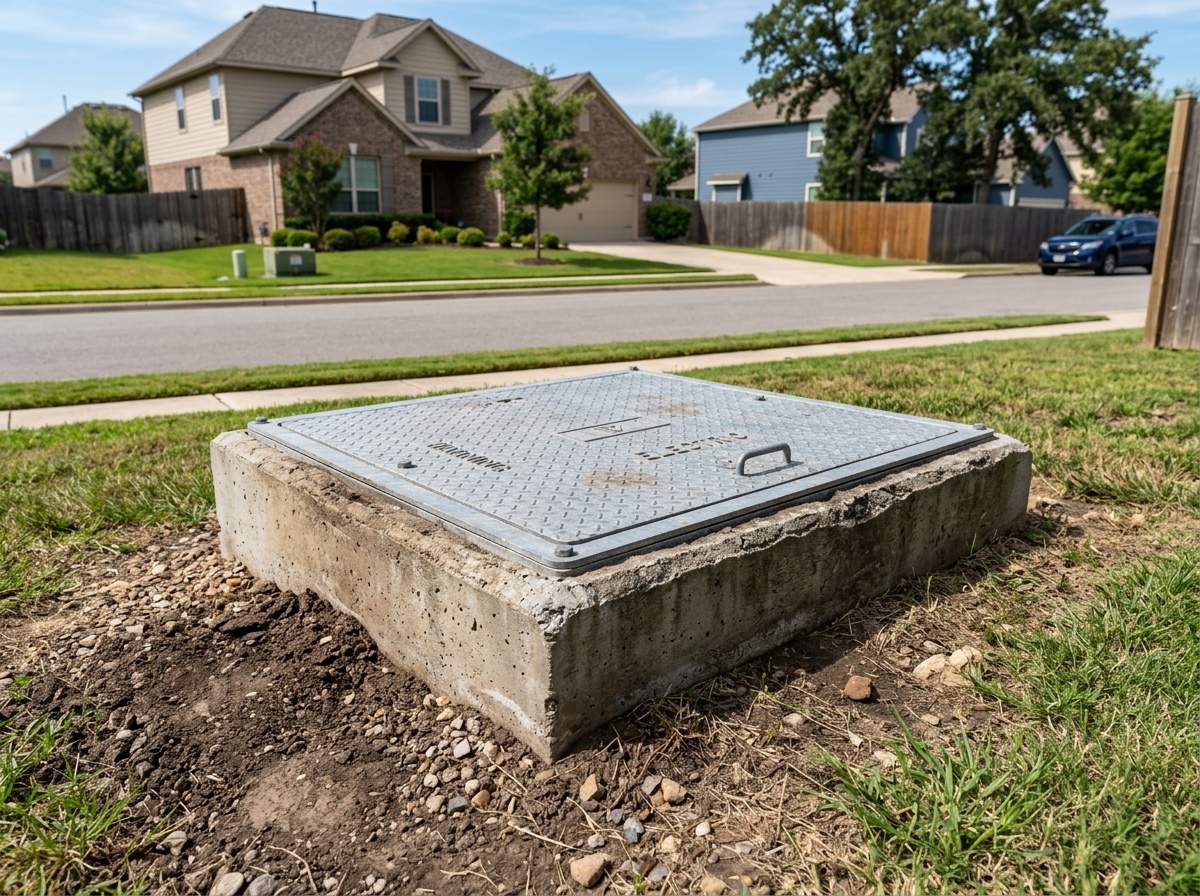

Pre-cast concrete power pit at property boundary - underground power pit installation

In the Carolinas, we see these most often in new residential subdivisions and commercial parks. These pits house the low-voltage supply connections and the service lateral—the cable that runs from the utility's main line to your property.

The industry is moving toward this model rapidly. According to the "50% Underground by 2040" whitepaper, there is a massive push for system hardening. By moving these assets into pits, we achieve several goals:

  • Safety: No high-voltage lines hanging overhead where they can be touched or knocked down.
  • Weather Protection: Underground assets are shielded from the ice storms and high winds we often see in North and South Carolina.
  • Asset Registration: These pits are logged into a central database (accessible via 811 "Call Before You Dig"), ensuring that future contractors don't accidentally strike them.

Why Underground Pits are Preferred Over Overhead Lines

While we all have a certain nostalgia for old-fashioned wooden power poles, they aren't exactly the peak of modern engineering. In our experience at RBC Utilities Inc., developers almost always prefer underground power pit installation for several reasons:

  1. Reliability: Underground systems aren't vulnerable to falling tree limbs—a major cause of outages in the wooded areas of the Carolinas.
  2. Vegetation Management: You don't have to constantly prune trees into awkward "V" shapes to keep them away from lines.
  3. Property Value: Let’s be honest: a clean horizon looks better than a web of black wires. Removing poles increases the curb appeal of any development.
  4. Public Safety: It eliminates the risk of poles being struck by vehicles or lines snapping during a storm.

Technical Specifications for a Successful Underground Power Pit Installation

Getting a pit in the ground isn't just about digging a hole and dropping in a box. It requires precise materials and engineering to ensure it lasts for decades.

Depending on the power needs of the site, you’ll either see a single-phase pit (standard for most homes) or a three-phase pit (common for commercial sites or large irrigation pumps). The pits themselves are usually made from pre-cast concrete or high-density fiberglass.

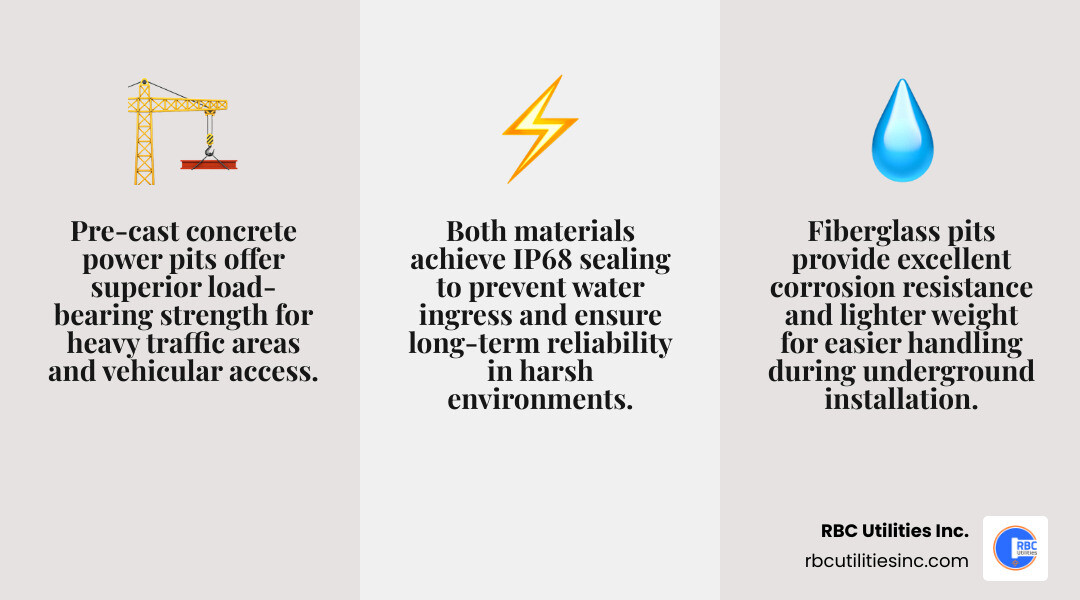

Infographic comparing pre-cast concrete and fiberglass power pits infographic

All pits must feature load-bearing lids capable of withstanding the weight of lawnmowers or vehicles if placed near a driveway. We also look for IP68-rated sealing to prevent water ingress, which can corrode connections over time.

Trenching, Conduit, and Backfill Requirements

The "veins" of this system are the conduits. For a safe underground power pit installation, we follow strict depth requirements:

  • Secondary Conduits (<600V): Must have a minimum cover of 24 inches.
  • Primary Conduits (>600V): Generally require 30 to 36 inches of cover, especially in state rights-of-way.

We typically use Schedule 40 PVC for straight runs, but for the "sweeps" or bends where the pipe turns up into the pit, we use Schedule 80 PVC elbows. These are thicker and can handle the friction of pulling heavy cables through them without wearing through the plastic.

Once the conduit is laid, we use "select backfill"—clean soil or sand free of large rocks that could pinch or puncture the pipe. We install red electrical warning tape about 12 inches above the conduit so that anyone digging in the future gets a visual warning before they hit the line. Finally, we include a tracer wire to allow for easy electronic locating.

Clearance and Accessibility Standards for Underground Power Pit Installation

Accessibility is a major factor in NESC (National Electrical Safety Code) compliance. A pit is useless if a utility technician can't get to it. We adhere to these standard Carolinas clearances:

  • Front Clearance: At least 10 feet of clear space in front of equipment access doors.
  • Side/Rear Clearance: At least 3 feet from shrubs, fences, or walls.
  • Property Lines: Pits are usually aligned exactly with property boundaries to avoid encroaching on private yards more than necessary.

If a pit is installed near a parking lot or road, we may also install vehicular barriers—usually concrete-filled steel bollards—to protect the asset from accidental impacts.

The Step-by-Step Request and Installation Process

If you're a developer in Charlotte or anywhere across the Carolinas, the process starts long before a shovel hits the dirt.

  1. Application Submission: You'll need to provide a detailed site plan and load calculations (how much power the building will actually draw).
  2. Design Preparation: The utility company reviews your request and creates a design. This usually takes about 20 business days for complex projects. You can find more details in this underground electricity supply application guide.
  3. Utility Offer: Once the design is ready, the utility sends an offer. This includes the cost you are responsible for.
  4. Acceptance Period: You typically have 30 to 45 business days to accept the offer and pay the fees.
  5. Field Assessment: Before construction, a field crew will visit the site to mark out the exact location and check for obstacles like water lines or existing trees.

Timelines and Potential Project Delays for Underground Power Pit Installation

In a perfect world, a pit is installed within 30 business days of the design being finalized. However, we’ve seen projects hit snags. Common delays include:

  • Permit Hurdles: Getting municipal approval for road crossings can take time.
  • Soil Conditions: If we hit solid rock (common in parts of the Piedmont), we may need specialized equipment.
  • Site Grading: The utility won't install the pit until the site is at "final grade." If the dirt is still moving, the pit might end up buried too deep or sticking out of the ground.
  • Easement Recording: All underground assets must have legal easements recorded before energization.

Costs, Responsibilities, and Compliance Standards

Who pays for what? In most cases, the developer or property owner covers the cost of the application and the construction labor for the pit itself.

  • Labor and Materials: This covers the physical pit, the conduit, and the crew's time.
  • Shared Distribution Costs: Also known as "upstream augmentation," these fees help the utility maintain the larger grid (substations and high-voltage feeders) that supports your new connection.
  • Developer vs. Utility Roles: Generally, the utility installs the pit and the primary lines. The developer is responsible for the trenching on their own property and the conduit system.

At RBC Utilities Inc., we handle the heavy lifting for developers to ensure everything meets NEC, NESC, and OSHA safety standards. You can find more info about our infrastructure services to see how we bridge the gap between the utility and your site.

Compliance is non-negotiable. Before a system is turned on, we must provide Private Mains drawings and ensure all assets match the utility's approved templates.

Advanced Methods and Post-Installation Procedures

Modern underground power pit installation has benefited greatly from trenchless technology. Instead of digging a massive trench across a paved road, we often use directional boring (Horizontal Directional Drilling).

We also use the "push-pull" method for cable installation. By using specialized machinery to both push and pull the cable simultaneously, we reduce the tension on the wire. This allows for longer runs with fewer junction pits, saving the developer money. To make this even smoother, we use engineered cable lubrication to reduce friction and prevent damage to the cable jacket.

Once the pit is in and the conduit is ready, the following happens:

  1. Energization: The utility pulls the main cable into the pit and connects it to the grid.
  2. REC Connection: You hire a Registered Electrical Contractor to connect the building to the pit.
  3. Permanent Reinstatement: About 6-8 weeks after the dust settles, a crew returns to finish topsoil repair, seed the grass, or patch any asphalt that was disturbed.

Frequently Asked Questions about Underground Power Pits

How much does an underground power pit cost?

While every project is different, a standard underground power pit installation in the Carolinas typically falls between $5,000 and $8,500. This includes application fees, labor, and materials. That "upstream" charges from the utility can vary based on how much work they need to do to the local substation to support your load.

How long does the installation process take?

From the moment you submit your application to the moment the pit is in the ground, expect a window of about 3 to 4 months. The physical installation only takes a few days, but the design review (20 days) and the utility's scheduling (30 days) make up the bulk of the timeline.

Who is responsible for connecting the pit to the building?

The utility company's responsibility ends at the pit. It is the developer's or homeowner's responsibility to hire a Registered Electrical Contractor (REC) to run the cables from the pit to the main switchboard of the building.

Conclusion

Building for the future means building underground. Whether you are developing a new neighborhood in Charlotte or upgrading a municipal site in South Carolina, underground power pit installation is the gold standard for reliability and safety.

At RBC Utilities Inc., we take pride in our Carolinas expertise. Backed by the national resources of Saga Infrastructure, we ensure your underground utility systems are built to last. From water and sewer to complex electrical conduit systems, we handle the infrastructure so you can focus on the build.

Ready to start your next project? Contact us for underground utility construction and let's get to work.
